What to Send for a Pipe Support Quotation — and What You Can Skip

TECH NOTE 07 — PIPEANCHOR SUPPLY ENGINEERING · JULY 2026

Most pipe support enquiries do not stall because the supplier is slow. They stall because a field is missing, the supplier writes back to ask, and two working days disappear into an email thread before anyone prices anything.

This note is the checklist we work from on our own quotation desk. Use it to assemble an enquiry that can be priced on first read — by us or by anyone else.

The minimum data set

Different support types need different fields. You rarely need all of them for one project.

A — ENGINEERED SUPPORTS (VARIABLE SPRING & CONSTANT HANGERS)
FieldWhy it is neededCan it be assumed?
Hot (operating) load per tagSets the spring size and working rangeNo
Vertical travel and directionSets load variability and the cold settingNo
Pipe size (NPS/DN)Sizes the clamp or attachmentNo
Design temperatureMaterial limits, insulation, finishPartly — ambient can be assumed if stated
ArrangementHanger, base-mounted or trapezeYes, if headroom is described instead
FinishPrimer, epoxy or hot-dip galvanizedYes — we quote primer unless told otherwise
B — RIGID & FABRICATED SUPPORTS (SHOES, GUIDES, ANCHORS)
FieldWhy it is neededCan it be assumed?
Pipe size and wallShoe width, saddle radius, weld detailNo
Insulation thicknessDecides shoe height — a 50 mm error makes the part uselessNo, if the line is insulated
Design temperatureHot or cold service; whether a thermal break is requiredNo
Axial / lateral movementGuide clearance, slide plate lengthYes for anchors; no for guides
Steel grade or project specPlate and section materialYes — carbon steel unless specified
C — BULK HARDWARE (CLAMPS, U-BOLTS, ROD, STRUT)
FieldWhy it is neededCan it be assumed?
Pipe size per line itemThe single field that sets the priceNo
Quantity per sizeTooling, batch and packingNo
TypeTwo-bolt, three-bolt, clevis, insulated, etc.Yes, if the application is described
FinishPrimer, epoxy or HDGYes — quoted both ways if unclear

Formats that work

The data matters; the container does not. All of these are enough to start:

  • A hanger schedule — the ideal case. One row per tag, priced line by line. See how to read a hanger schedule if you are building one.
  • A marked-up stress isometric — loads and movements noted at the support points carry exactly the same information. A photograph of a marked-up print is fine.
  • A BOQ extract — for bulk hardware, the support section of the bill of quantities is usually complete already.
  • Nameplate photographs — for replacements in an operating plant. A legible nameplate carries load range, travel and often the original tag, which is enough to size a like-for-like unit.
  • A plain list in the email body — for a handful of tags, typed lines work as well as a spreadsheet.
Partial data is still worth sending. A schedule with three of six columns filled gets a preliminary price and a short list of what is missing — which is faster than waiting until the schedule is complete.

Record the installation interface before identifying the assembly

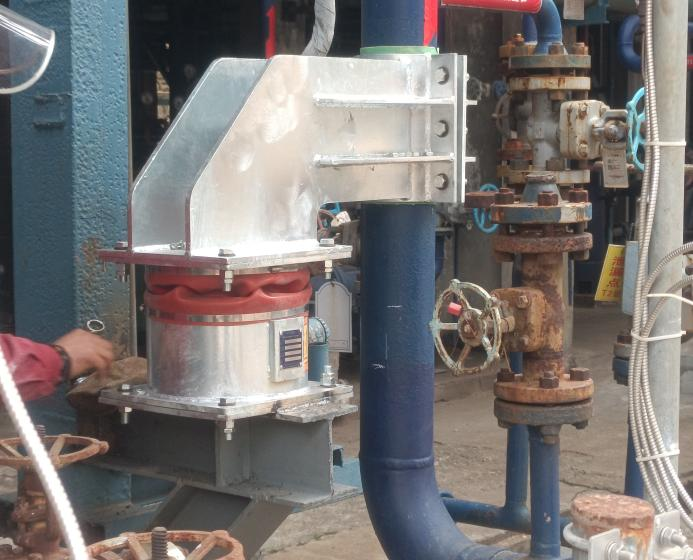

A field photo can strengthen an RFQ when it is used as an interface record, not as a substitute for a drawing or readable tag. In the view below, a metallic installed assembly, bolted interfaces, surrounding pipework and hand-operated valves are visible. The small nameplate is not readable in the supplied image, so the photograph does not establish the equipment type, size, capacity, material or suitability.

Field photo of a metallic installed assembly with bolted interfaces beside industrial pipework and valves; product identity is not established
REAL FIELD PHOTO — RECORD VISIBLE INTERFACES; KEEP PRODUCT IDENTITY AND SELECTION DATA TBC
TURN ONE FIELD PHOTO INTO A CONTROLLED RFQ RECORD
Record layerWhat this image supportsNext RFQ action
Confirmed from the photoInstalled metallic assembly; visible bolted interfaces; adjacent pipework and valvesRetain the original file, record its source and receipt date, and state the view direction if known
TBC from drawing or tagProduct identity, tag or drawing reference, connection sizes and orientationRequest a wider view, connection close-ups and a readable tag or controlled drawing
Not established by this viewDimensions, design load or stroke, material grade, service conditions and compliance basisLeave each field blank or mark it TBC; do not replace missing evidence with an estimate

For procurement, this three-layer record is more useful than an unsupported equipment label. It tells the supplier what can be reviewed immediately and turns every unknown into a specific evidence request. Attach the original photo set to the schedule, marked-up drawing or BOQ already being sent; if the interface is still unclear, include the missing-view list in the quotation request.

The three gaps that cause most delays

Across the enquiries that reach us, the same three fields go missing. None of them can be guessed:

  1. Travel without direction. "30 mm" does not say whether the pipe rises or falls going hot. The cold load moves in opposite directions for the two cases, so the installation setting cannot be issued.
  2. A load with no state. A single load figure with no note of hot or cold forces the supplier to assume — and an assumption on this field puts the spring at the wrong end of its range.
  3. Insulation thickness on shoe and clamp lines. An insulated line quoted as bare produces shoes that are the wrong height. This one is not recoverable on site.

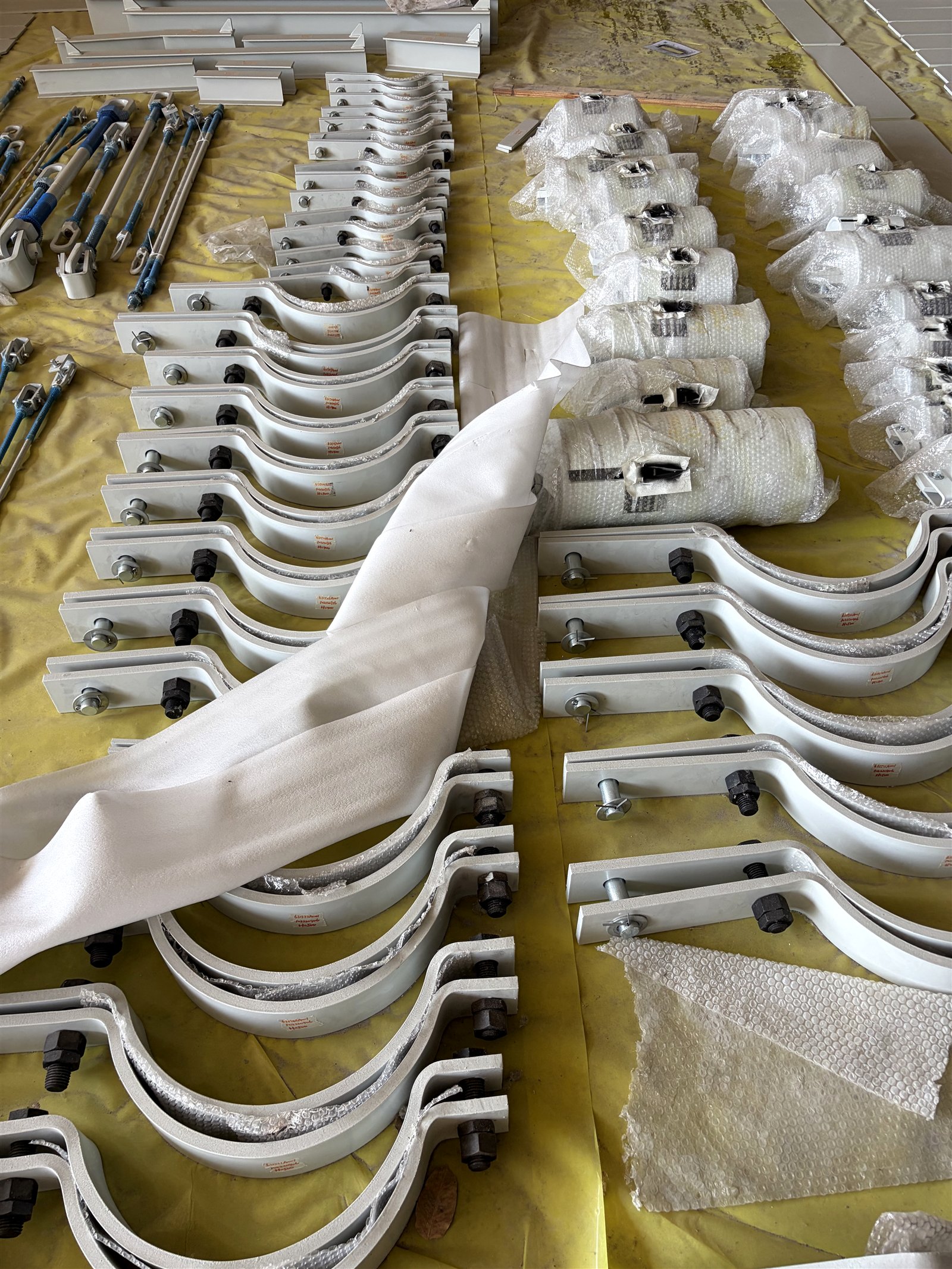

Rows of finished pipe clamps individually tagged before packing
EVERY ITEM TAGGED TO MATCH THE SCHEDULE IT WAS QUOTED FROM — OUR PRODUCTION FLOOR

What you can skip

  • A full 3D model. Useful later, unnecessary for pricing. Loads and movements are what get priced.
  • Final drawing approval. Preliminary loads are enough for a preliminary price; both get revised together.
  • Your own model-number selection. If you have already selected sizes we will check them, but you do not need to. Give us loads and travel and we will size it — and say so if a tag needs a constant support instead of a variable spring.

What comes back

WHAT AN ENQUIRY SHOULD PRODUCE
DeliverableDetail
Itemized quotationPriced per tag or per line item, not a single lump sum
Data sheet per tagSelected size, spring rate, hot and cold loads, travel, arrangement
Queries listAny field we had to assume, stated explicitly so you can correct it
Lead time and packing basisWorking days from drawing approval; export crating included

On our desk that turnaround is within 24 hours on working days for a schedule that arrives complete. Incomplete schedules get a preliminary price in the same window, with the gaps listed.

Copy-paste enquiry template

For a first enquiry, this is enough:

Project / location:
Standard or spec (e.g. MSS SP-58 or project spec):
Finish required (primer / epoxy / HDG):

Per tag:
Tag no. | Pipe size | Design temp | Hot load | Travel + direction | Arrangement | Insulation thickness

Bulk items:
Type | Pipe size | Quantity | Finish

Required delivery date:

Fill in what you have, leave the rest blank, and send it to sales@pipeanchorsupply.com or by WhatsApp. We will price what is priceable and list what is not.
